Compressed Timeline Model

Three material tracks in parallel. 24 days from requirement confirmation to completed evaluation samples — a process that takes 12+ weeks when run sequentially.

Growth-Stage Brand
Mar 26, 2026
24

24 days from requirement confirmation to completed evaluation samples — three material tracks running in parallel compressed a 12+ week sequential process

Engineering Story

Traditional product development timelines are sequential — and traditional sampling logic compounds the problem. Most teams either combine appearance and performance evaluation into a single sample run (saving cost but delaying everything until all parameters are finalized), or use fragmented samples that show different features on separate pieces (saving cost but destroying the holistic product experience). Both approaches sacrifice either time or quality.

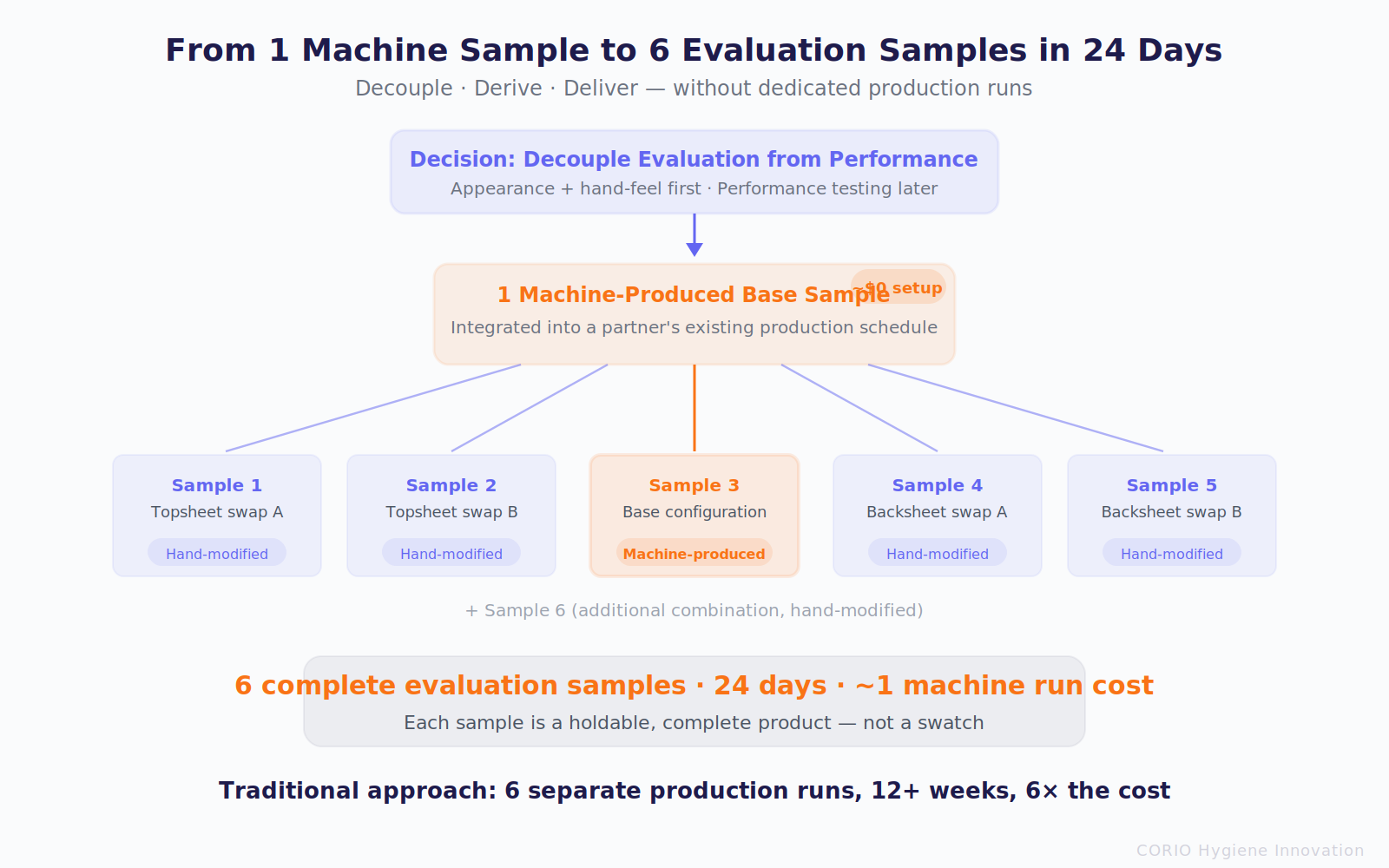

Compressed Timeline: three material tracks running in parallel reduce 12+ weeks to 28 days without sacrificing any screening gate


We made three engineering decisions that compressed the timeline without sacrificing either.


First, we decoupled evaluation from performance. The client needed samples for a retail channel review — appearance and hand-feel, not absorption data. By separating the evaluation sample track from the future performance sample track, we eliminated the dependency that forces most teams to wait until all specifications are locked before producing anything physical.


Second, we designed a hybrid machine-plus-handmade sampling architecture. Of the six material combination samples delivered to the client, only one was produced on a converting line. The other five were hand-engineered from that base sample — selectively replacing the topsheet or backsheet layer to demonstrate different material combinations. Each sample was a complete, holdable product — not a swatch book. Six configurations delivered at roughly the cost of one machine run.


Third, even the single machine-produced sample was not a standalone production request. During supplier coordination, we identified that one converting partner had an upcoming production run with specifications closely matching our target. We integrated our sample into that existing schedule — one additional configuration added to a run that was already happening. No dedicated machine setup, no standalone minimum order.


The result: 24 days from requirement confirmation to six complete evaluation samples in the client's hands — each demonstrating a distinct material combination for appearance and hand-feel assessment. The client could physically compare options side by side, as complete products rather than isolated material swatches. A conventional approach (contrast with the three-layer time margin methodology and critical path decomposition) to the same scope would have required 12 or more weeks and significantly higher sampling costs.


Why Only CORIO

Most suppliers provide a timeline as a commitment number — "delivery in X weeks." Our timeline model is an engineering structure — each parallel line has an independent minimum buffer, critical-path dependencies are explicitly annotated, and risk nodes have predefined fallback plans. Time is not "promised" — it is "engineered."

Client Voice
“When the client's retail channel timeline faced uncertainty, she discovered our supply chain preparation was already complete — prototype samples across multiple configurations were ready, awaiting confirmation to ship. She said this was the first supplier she had worked with that was "ready and waiting for you."”
